Tutorial:
Features
- ASP.NET Gantt control
- Customizable scale - we are displaying one cell per day
- Customizable time header - we are displaying days grouped by month
- Adding a new task using a modal dialog
- Editing a task using a modal dialog
- PNG Export
- PDF Export
- Customizable PDF page format (Letter, A4)
- Customizable PDF page orientation (portrait, landscape)
- Visual Studio 2012 solution
The tutorial source code (C#, VB.NET) is available for download.
Example

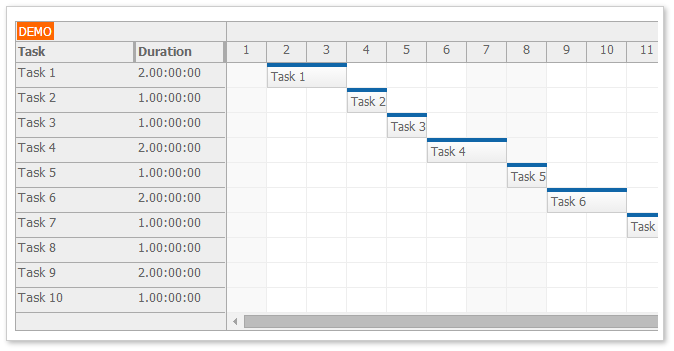

Basic Gantt configuration (ASP.NET):
<DayPilot:DayPilotScheduler
runat="server"
ID="GanttControl"
ViewType="Gantt"
Scale="Day"
>
<TimeHeaders>
<DayPilot:TimeHeader GroupBy="Month" Format="MMMM yyyy" />
<DayPilot:TimeHeader GroupBy="Cell" />
</TimeHeaders>
<HeaderColumns>
<DayPilot:RowHeaderColumn Title="Task" Width="120" />
<DayPilot:RowHeaderColumn Title="Duration" Width="90" />
</HeaderColumns>
</DayPilot:DayPilotScheduler>The PDF export method uses the open-source PDFSharp library to create the PDF file (C#):
private void ExportToPdf()
{
// create a new PDF document
PdfDocument doc = new PdfDocument();
doc.Info.Title = "Gantt Chart PDF Export";
doc.Info.Author = "DayPilot";
// add a page
PdfPage page = doc.AddPage();
// set PDF page properties (size and orientation)
page.Size = (PageSize) Enum.Parse(typeof (PageSize), ListPageSize.SelectedValue);
page.Orientation = (PageOrientation)Enum.Parse(typeof(PageOrientation), ListPageOrientation.SelectedValue);
// create graphics object for PDF page modification
XGraphics gfx = XGraphics.FromPdfPage(page);
// write title
XRect titleRect = new XRect(new XPoint(), gfx.PageSize);
titleRect.Inflate(-10, -15);
XFont font = new XFont("Tahoma", 14, XFontStyle.Bold);
gfx.DrawString("DayPilot Gantt PDF Export", font, XBrushes.DarkGray, titleRect, XStringFormats.TopCenter);
// create the Gantt image
SetDataSourceAndBind();
SetExportProperties();
Bitmap bitmap = GanttControl.ExportBitmap();
// add the image to the PDF page
XImage image = XImage.FromGdiPlusImage(bitmap);
XRect imageRect = GetPaddedRectForImage(gfx, image, 10);
double y = 40;
imageRect.Y = y;
gfx.DrawImage(image, imageRect);
// save the PDF file to MemoryStream
MemoryStream mem = new MemoryStream();
doc.Save(mem, false);
// send the output stream to the browser
Response.Clear();
Response.ContentType = "application/pdf";
Response.AddHeader("content-disposition", "attachment;filename=gantt.pdf");
mem.WriteTo(Response.OutputStream);
Response.End();
}
